Deck 13: Resource Planning

Full screen (f)
exit full mode
Question
Table 13.3
Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s).
Week
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item    Master Production Schedule: the following table shows the MPS start quantities. Use the information in Table 13.3. Which one of the following statements about item E is TRUE?</strong> A) There will be an action notice to expedite the scheduled receipt up to week 2. B) There is one planned receipt for the next 6 weeks. C) There is a planned order release of 250 units in week 3. D) There is a planned receipt of 250 units in week 2. <div style=padding-top: 35px>
Bill of Material
-End item A uses 1 each of component C and 1 each of subassembly D.
-Subassembly D uses 2 each of component E and 2 each of component F.
-End item B uses 1 each of component C and 2 each of component F.
Selected Inventory Data
Item
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item    Master Production Schedule: the following table shows the MPS start quantities. Use the information in Table 13.3. Which one of the following statements about item E is TRUE?</strong> A) There will be an action notice to expedite the scheduled receipt up to week 2. B) There is one planned receipt for the next 6 weeks. C) There is a planned order release of 250 units in week 3. D) There is a planned receipt of 250 units in week 2. <div style=padding-top: 35px>

Master Production Schedule: the following table shows the MPS start quantities.
Use the information in Table 13.3. Which one of the following statements about item E is TRUE?

A) There will be an action notice to expedite the scheduled receipt up to week 2.
B) There is one planned receipt for the next 6 weeks.
C) There is a planned order release of 250 units in week 3.
D) There is a planned receipt of 250 units in week 2.
Use Space or
up arrow
down arrow
to flip the card.
Question
One of the differences between Enterprise Resource Planning (ERP) and MRPII is that

A) ERP is limited to operations internal to the enterprise.
B) ERP is linked to the external supply chain, but MRPII is not.
C) ERP applies only to those operations that are external to the enterprise.
D) ERP includes both manufacturing and service operations.
Question
The action notice is a

A) secret document to prompt actions to be taken against some suppliers.
B) computer- generated document that helps make decisions about releasing new orders.
C) document that records the most recent important actions taken in the context of MRP.
D) legal notice served by a customer whose order was delayed.

Question
Table 13.6
<strong>Table 13.6   Use the information from Table 13.6. What is the planned receipts quantity in week 3?</strong> A) 0 units B) 10 units C) 20 units D) 30 units <div style=padding-top: 35px>
Use the information from Table 13.6. What is the planned receipts quantity in week 3?

A) 0 units
B) 10 units
C) 20 units
D) 30 units
Question
Complete the following MRP record in order to answer the question. <strong>Complete the following MRP record in order to answer the question.   How many action notices will there be for item XYZ?</strong> A) 0 B) 1 C) 2 D) 3 or more <div style=padding-top: 35px> How many action notices will there be for item XYZ?

A) 0
B) 1
C) 2
D) 3 or more
Question
Management wishes to use a POQ lot- sizing rule for an item that experiences an average demand of 30 units per week. If the desired average lot size is 120 units, what should P be?

A) 0 or 1 weeks
B) 2 or 3 weeks
C) 4 or 5 weeks
D) More than 5 weeks
Question
Which best defines the gross requirements for a component item?

A) the forecasted customer demand for the component
B) the total demand for the component derived from all immediate parents
C) the sum of gross requirements for all parents of the component
D) the amount of safety stock needed to buffer against uncertainties
Question
Which of the following statements about MRP II is TRUE?

A) It provides more extensive information than MRP because it is tied to the company's financial system.
B) It incorporates informal systems through the use of expert systems technology.
C) It is computationally faster than regular MRP.
D) It is limited only to aiding order- launching decisions.
Question
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   How large is the second planned order release?</strong> A) less than or equal to 50 units B) greater than 50 units but less than or equal to 100 units C) greater than 100 units but less than or equal to 150 units D) greater than 150 units <div style=padding-top: 35px> How large is the second planned order release?

A) less than or equal to 50 units
B) greater than 50 units but less than or equal to 100 units
C) greater than 100 units but less than or equal to 150 units
D) greater than 150 units
Question
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   What are the quantities of planned order releases for item DEF for the first five weeks (weeks 1, 2, 3, 4, and 5)?</strong> A) 0, 30, 60, 0, 0 B) 30, 0, 60, 145, 0 C) 60, 0, 145, 0, 0 D) 30, 0, 60, 0, 145 <div style=padding-top: 35px> What are the quantities of planned order releases for item DEF for the first five weeks (weeks 1, 2, 3, 4, and 5)?

A) 0, 30, 60, 0, 0
B) 30, 0, 60, 145, 0
C) 60, 0, 145, 0, 0
D) 30, 0, 60, 0, 145
Question
The purpose of Finite Capacity Scheduling is to

A) schedule a group of jobs across all work centers.
B) schedule all jobs for a finite amount of time.
C) limit the total capacity to be used in a day.
D) schedule by hand when MRP fails.
Question
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   How many action notices are needed for item A?</strong> A) 0 B) 1 C) 2 D) 3 or more <div style=padding-top: 35px> How many action notices are needed for item A?

A) 0
B) 1
C) 2
D) 3 or more
Question
Table 13.5.
<strong>Table 13.5.   Use the information in Table 13.5. Which of the statements concerning item RST is TRUE? (Examine each answer independently.)</strong> A) If the scheduled receipt in week 2 were delayed until week 3, there would be a planned order release in week 1. B) If the gross requirements for week 8 were 100 units instead of 60 units, the projected on- hand inventory for week 8 would be 0 units. C) If the safety stock level was 20 units instead of 0 units, there would be a planned order release in week 2. D) If the safety stock level were 30 units instead of 0 units, the planned receipt in week 7 would be 110 units. <div style=padding-top: 35px>
Use the information in Table 13.5. Which of the statements concerning item RST is TRUE? (Examine each answer independently.)

A) If the scheduled receipt in week 2 were delayed until week 3, there would be a planned order release in week 1.
B) If the gross requirements for week 8 were 100 units instead of 60 units, the projected on- hand inventory for week 8 would be 0 units.
C) If the safety stock level was 20 units instead of 0 units, there would be a planned order release in week 2.
D) If the safety stock level were 30 units instead of 0 units, the planned receipt in week 7 would be 110 units.
Question
Which one of the following is an MRP lot- sizing rule that attempts to minimize the amount of average inventory?

A) Fixed order quantity (FOQ)
B) Periodic order quantity (POQ), with P = 2
C) Economic order quantity (EOQ)
D) Lot for lot (L4L)
Question

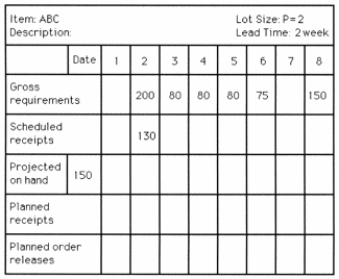

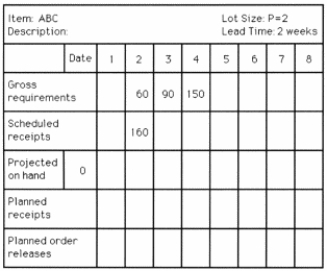

Table 13.7.
<strong>Table 13.7.   Use the information from Table 13.7. If a POQ lot- sizing rule is used, where P = 3, how many planned order releases are there for item XYZ?</strong> A) 0 or 1 B) 2 or 3 C) 4 or 5 D) more than 5 <div style=padding-top: 35px>
Use the information from Table 13.7. If a POQ lot- sizing rule is used, where P = 3, how many planned order releases are there for item XYZ?

A) 0 or 1
B) 2 or 3
C) 4 or 5
D) more than 5
Question
A technique for projecting time- phased requirements for critical workstations is a definition of

A) distribution requirements planning.
B) capacity requirements planning.
C) manufacturing resource planning.
D) material requirements planning.
Question
Which of the following statements about MRP is TRUE?

A) MRP may generate a planned order release that exceeds current production capacity.
B) MRP always recognizes capacity limitations in production as well as human resources.
C) Capacity limitations are implicit in all MRP calculations.
D) MRP recognizes the capacity limitations in production, but not in human resources.
Question
Table 13.7
<strong>Table 13.7   Use the information from Table 13.7. If a FOQ of 75 units is used, how many planned order releases are there for item XYZ?</strong> A) 0 or 1 B) 2 or 3 C) 4 or 5 D) more than 5 <div style=padding-top: 35px>
Use the information from Table 13.7. If a FOQ of 75 units is used, how many planned order releases are there for item XYZ?

A) 0 or 1
B) 2 or 3
C) 4 or 5
D) more than 5
Question
Table 13.3
Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s).
Master Production Schedule: the following table shows the MPS start quantities.
Week
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item   Use the information in Table 13.3. Which one of the following statements about item C is TRUE?</strong> A) It has a planned receipt of 80 units in week 3. B) It has a planned receipt of 180 units in week 6. C) Its first planned order release is for 130 units in week 1. D) Its second planned order release is for 200 units in week 3. <div style=padding-top: 35px>
Bill of Material
-End item A uses 1 each of component C and 1 each of subassembly D.
-Subassembly D uses 2 each of component E and 2 each of component F.
-End item B uses 1 each of component C and 2 each of component F.
Selected Inventory Data
Item
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item   Use the information in Table 13.3. Which one of the following statements about item C is TRUE?</strong> A) It has a planned receipt of 80 units in week 3. B) It has a planned receipt of 180 units in week 6. C) Its first planned order release is for 130 units in week 1. D) Its second planned order release is for 200 units in week 3. <div style=padding-top: 35px>
Use the information in Table 13.3. Which one of the following statements about item C is TRUE?

A) It has a planned receipt of 80 units in week 3.
B) It has a planned receipt of 180 units in week 6.
C) Its first planned order release is for 130 units in week 1.
D) Its second planned order release is for 200 units in week 3.
Question
A term for systems that are large, integrated information systems which support many enterprise processes and data storage needs is called

A) standard resource planning.
B) material resource planning.
C) enterprise resource planning.
D) effective resource planning.
Question
Which one of the following statements concerning MRP is TRUE?

A) The scheduled receipts for a parent item are used to calculate the gross requirements for components of that parent.
B) Some of the key inputs to a computerized MRP system are inventory records, updated bills of material, and a valid master production schedule.
C) One of the main prerequisites for implementing an MRP system is to have products with few BOM levels.
D) Benefits of a successful MRP implementation typically include a decrease in the number of inventory turns, and an increase in the number of expediters.

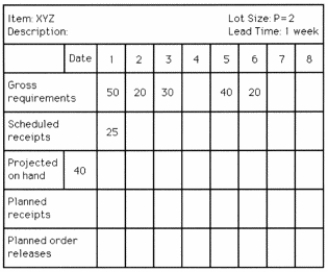

Question
Table 13.1
<strong>Table 13.1   Use the information in Table 13.1. In which week will the second planned order release occur?</strong> A) Week 1 B) Week 2 C) Week 3 D) Week 4, 5, 6, 7 or 8 <div style=padding-top: 35px>
Use the information in Table 13.1. In which week will the second planned order release occur?

A) Week 1
B) Week 2
C) Week 3
D) Week 4, 5, 6, 7 or 8
Question
Table 13.3
Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s).
Master Production Schedule: the following table shows the MPS start quantities.
Week
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item   Use the information in Table 13.3. Which one of the following statements on item C is TRUE?</strong> A) There will be more than two action notices. B) There will be exactly two action notices, to release a new order and delay the scheduled receipt. C) There will be exactly one action notice, to release a new order. D) There will be no action notices for item C. <div style=padding-top: 35px>
Bill of Material
-End item A uses 1 each of component C and 1 each of subassembly D.
-Subassembly D uses 2 each of component E and 2 each of component F.
-End item B uses 1 each of component C and 2 each of component F.
Selected Inventory Data
Item
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item   Use the information in Table 13.3. Which one of the following statements on item C is TRUE?</strong> A) There will be more than two action notices. B) There will be exactly two action notices, to release a new order and delay the scheduled receipt. C) There will be exactly one action notice, to release a new order. D) There will be no action notices for item C. <div style=padding-top: 35px>
Use the information in Table 13.3. Which one of the following statements on item C is TRUE?

A) There will be more than two action notices.
B) There will be exactly two action notices, to release a new order and delay the scheduled receipt.
C) There will be exactly one action notice, to release a new order.
D) There will be no action notices for item C.
Question
Table 13.5.
<strong>Table 13.5.   Use the information in Table 13.5. Which one of the statements concerning item RST is TRUE?</strong> A) The first planned receipt occurs in week 5. B) There are exactly two planned order releases needed. C) There is an action notice needed to expedite the schedule receipt by one week. D) The planned receipt in week 7 is 80 units. <div style=padding-top: 35px>
Use the information in Table 13.5. Which one of the statements concerning item RST is TRUE?

A) The first planned receipt occurs in week 5.
B) There are exactly two planned order releases needed.
C) There is an action notice needed to expedite the schedule receipt by one week.
D) The planned receipt in week 7 is 80 units.
Question
Table 13.8
Sunshine Manufacture produces three products, X, Y, and Z. The production of these end items is controlled by an MRP
system. Each end item X is assembled with two components of A and one component of B. Each end item of Y is assembled
with two components of C and one component of A, each component of C is manufactured from one unit of B. End item Z is
assembled from one unit of D and one unit of C, D is manufactured from one unit of A, and C is manufactured from one unit
of B.
Use the information in Table 13.8. If level- by- level processing is used, what is a correct order for processing components A, B, C, and D?

A) A B C D
B) D A B C
C) C B A D
D) C D A B
Question
Table 13.3
Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s).
Master Production Schedule: the following table shows the MPS start quantities.
Week
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item   Use the information in Table 13.3. Which one of the following statements about item F is TRUE?</strong> A) Its first planned receipt is for 215 units in week 4. B) There will be exactly one action notice, which calls for the release of a new order. C) There will be exactly one action notice, which calls for the delay of the scheduled receipt until week 2. D) The first planned order release is for 205 units in week 3. <div style=padding-top: 35px>
Bill of Material
-End item A uses 1 each of component C and 1 each of subassembly D.
-Subassembly D uses 2 each of component E and 2 each of component F.
-End item B uses 1 each of component C and 2 each of component F.
Selected Inventory Data
Item
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item   Use the information in Table 13.3. Which one of the following statements about item F is TRUE?</strong> A) Its first planned receipt is for 215 units in week 4. B) There will be exactly one action notice, which calls for the release of a new order. C) There will be exactly one action notice, which calls for the delay of the scheduled receipt until week 2. D) The first planned order release is for 205 units in week 3. <div style=padding-top: 35px>
Use the information in Table 13.3. Which one of the following statements about item F is TRUE?

A) Its first planned receipt is for 215 units in week 4.
B) There will be exactly one action notice, which calls for the release of a new order.
C) There will be exactly one action notice, which calls for the delay of the scheduled receipt until week 2.
D) The first planned order release is for 205 units in week 3.
Question
Table 13.7
<strong>Table 13.7   Use the information from Table 13.7. If a FOQ of 100 units is used, how many planned order releases are there for item XYZ?</strong> A) 0 or 1 B) 2 or 3 C) 4 or 5 D) more than 5 <div style=padding-top: 35px>
Use the information from Table 13.7. If a FOQ of 100 units is used, how many planned order releases are there for item XYZ?

A) 0 or 1
B) 2 or 3
C) 4 or 5
D) more than 5
Question
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   What are the quantity and the week of the first planned order release?</strong> A) 150 units: week 2 B) 140 units; week 2 C) 150 units; week 1 D) 20 units; week 1 <div style=padding-top: 35px> What are the quantity and the week of the first planned order release?

A) 150 units: week 2
B) 140 units; week 2
C) 150 units; week 1
D) 20 units; week 1
Question
Which one of the following statements about lot- sizing rules is TRUE?

A) If the POQ rule is used, an item's lot size can vary each time an order is placed.
B) The periodic order quantity (POQ) rule seeks to create inventory remnants.
C) The lot for lot (L4L) rule is a special case of the fixed order quantity (FOQ) rule.
D) All lot- sizing rules seek to minimize inventory levels.
Question
Table 13.2.
<strong>Table 13.2.   Use the information in Table 13.2. How many planned order releases are there for item XYZ?</strong> A) 3 B) 4 or more C) 0 D) 1 or 2 <div style=padding-top: 35px>
Use the information in Table 13.2. How many planned order releases are there for item XYZ?

A) 3
B) 4 or more
C) 0
D) 1 or 2
Question
Which one of the following systems is an input to the MRP system?

A) purchasing system
B) master production scheduling system
C) financial reporting system
D) shop floor scheduling system
Question
Use the following MRP record to answer the following question. <strong>Use the following MRP record to answer the following question.   What is the planned order release quantity in week 4?</strong> A) 0 units B) greater than 0 units but less than or equal to 50 units C) greater than 50 units but less than or equal to 100 units D) greater than 100 units <div style=padding-top: 35px> What is the planned order release quantity in week 4?

A) 0 units
B) greater than 0 units but less than or equal to 50 units
C) greater than 50 units but less than or equal to 100 units
D) greater than 100 units
Question
Planned lead time for purchased items is

A) order processing time.
B) setup time plus materials handling time plus waiting time.
C) time difference between when the order was issued and when it would be received from the supplier.
D) setup time plus processing time plus waiting time.
Question
The underlying logic for level- by- level processing in an MRP system is

A) all parents of an item must be processed before that item is processed.
B) items without safety stock quantities must be processed before items that have safety stocks greater than zero.
C) each item in a bill of material must be processed from the bottom up.
D) items must be processed in order of increasing lead time.
Question
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   What are the quantities of planned order releases for item XYZ for the first six weeks (weeks 1, 2, 3, 4, 5, and 6)?</strong> A) 35, 0, 60, 0, 0, 0 B) 5, 30, 0, 40, 20, 0 C) 35, 0, 0, 40, 20, 0 D) 35, 0, 0, 60, 0, 0 <div style=padding-top: 35px> What are the quantities of planned order releases for item XYZ for the first six weeks (weeks 1, 2, 3, 4, 5, and 6)?

A) 35, 0, 60, 0, 0, 0
B) 5, 30, 0, 40, 20, 0
C) 35, 0, 0, 40, 20, 0
D) 35, 0, 0, 60, 0, 0
Question
A resource planning process takes

A) buying and production plan; processes information in the way of time standards, routings, and other information on how the firm produces its services or products; and then plans the input requirements.
B) sales and operation plan; processes information in the way of time standards, routings, and other information on how the firm produces its services or products; and then plans the input requirements.
C) marketing and distribution plan; processes information in the way of time standards, routings, and other information on how the firm produces its services or products; and then plans the input requirements.
D) modelling and branding plan; processes information in the way of time standards, routings, and other information on how the firm produces its services or products; and then plans the input requirements.
Question
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   What will be the projected on- hand inventory quantity in week 8?</strong> A) less than or equal to 30 units B) greater than 30 units but less than or equal to 60 units C) greater than 60 units but less than or equal to 90 units D) greater than 90 units <div style=padding-top: 35px> What will be the projected on- hand inventory quantity in week 8?

A) less than or equal to 30 units
B) greater than 30 units but less than or equal to 60 units
C) greater than 60 units but less than or equal to 90 units
D) greater than 90 units
Question
Table 13.7.
<strong>Table 13.7.   Use the information from Table 13.7. If a L4L lot- sizing rule is used, how many planned order releases are there for item XYZ?</strong> A) 0 or 1 B) 2 or 3 C) 4 or 5 D) more than 5 <div style=padding-top: 35px>
Use the information from Table 13.7. If a L4L lot- sizing rule is used, how many planned order releases are there for item XYZ?

A) 0 or 1
B) 2 or 3
C) 4 or 5
D) more than 5
Question
One of the three types of MRP action notices possible is releasing a new order. Which one of the following statements is TRUE about releasing a new order?

A) Release an order when the first period's gross requirements quantity is equal to zero.
B) Release a separate order for service parts.
C) Release an order when there is a nonzero quantity in the scheduled receipt row.
D) Release an order when there is a nonzero quantity in the first period's planned order release row.
Question
MRP explosion means estimating the total number of

A) parts to be produced for each parent item.
B) parts needed to be produced less the number of parts on hand for each parent item.
C) raw materials to be purchased from all suppliers.
D) subassemblies, components, and raw materials needed for each parent item.
Question
Table 13.6.
<strong> Table 13.6.   Use the information from Table 13.6. If the lot- sizing rule were L4L instead of FOQ = 30 units, what would be the planned order release quantity week 1?</strong> A) 0 units B) 10 units C) 20 units D) 40 units <div style=padding-top: 35px>
Use the information from Table 13.6. If the lot- sizing rule were L4L instead of FOQ = 30 units, what would be the planned order release quantity week 1?

A) 0 units
B) 10 units
C) 20 units
D) 40 units
Question
Management wishes to use a FOQ lot- sizing rule for an item based on the economic order quantity. If the annual demand is 1200 units, the holding cost is $10/unit/year, and the setup cost is $50/lot, which one of the following fixed order quantities is most appropriate?

A) 90 units
B) 110 units
C) 130 units
D) 150 units
Question
Which of the following statements on MRP is TRUE?

A) MRP is an inventory control system that derives the gross requirements of the end items from purchase commitments with vendors.
B) The payoffs from MRP tend to be greater when there are more BOM levels and larger lot sizes.
C) The fixed order quantity (FOQ) eliminates remnants.
D) When MRP systems are enhanced to include financial reporting they are called basic MRP systems, or "little mrp."
Question
Table 13.4
Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS
start quantities.
Week
<strong>Table 13.4 Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B. -Subassembly B uses 1 each of component D. Selected Inventory Data Item   Use the information in Table 13.4. What are the total planned receipts for item D? (Sum up the planned receipts for all periods.)</strong> A) less than or equal to 80 units B) greater than 80 units but less than or equal to 100 units C) greater than 100 units but less than or equal to 240 units D) greater than 240 units. <div style=padding-top: 35px>
Bill of Material
-Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B.
-Subassembly B uses 1 each of component D.
Selected Inventory Data
Item
<strong>Table 13.4 Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B. -Subassembly B uses 1 each of component D. Selected Inventory Data Item   Use the information in Table 13.4. What are the total planned receipts for item D? (Sum up the planned receipts for all periods.)</strong> A) less than or equal to 80 units B) greater than 80 units but less than or equal to 100 units C) greater than 100 units but less than or equal to 240 units D) greater than 240 units. <div style=padding-top: 35px>
Use the information in Table 13.4. What are the total planned receipts for item D? (Sum up the planned receipts for all periods.)

A) less than or equal to 80 units
B) greater than 80 units but less than or equal to 100 units
C) greater than 100 units but less than or equal to 240 units
D) greater than 240 units.
Question
Table 13.4
Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS
start quantities.
Week
<strong>Table 13.4 Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B. -Subassembly B uses 1 each of component D. Selected Inventory Data Item   Use the information in Table 13.4. When does the first planned order release for item C occur?</strong> A) Week 1 or 2 B) Week 3 C) Week 4 D) No planned order releases needed <div style=padding-top: 35px>
Bill of Material
-Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B.
-Subassembly B uses 1 each of component D.
Selected Inventory Data
Item
<strong>Table 13.4 Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B. -Subassembly B uses 1 each of component D. Selected Inventory Data Item   Use the information in Table 13.4. When does the first planned order release for item C occur?</strong> A) Week 1 or 2 B) Week 3 C) Week 4 D) No planned order releases needed <div style=padding-top: 35px>
Use the information in Table 13.4. When does the first planned order release for item C occur?

A) Week 1 or 2
B) Week 3
C) Week 4
D) No planned order releases needed
Question
Which of the following statements about lot- sizing rules for MRP is TRUE?

A) The lot- for- lot rule minimizes inventory investment, but maximizes the number of orders placed.
B) The periodic order quantity (POQ) rule generates a higher level of average inventory, because it creates inventory remnants.
C) In general, the fixed order quantity rule introduces greater instability into the production process.
D) FOQ reduces the amount of inventory on hand, by doing a better job of matching the order quantity the projected on- hand inventory quantity.
Question
Table 13.1.
<strong>Table 13.1.   Use the information in Table 13.1. If the safety stock level were 30 units instead of 0 units, in which week would the first planned receipt occur?</strong> A) Week 1 B) Week 2 or 3 C) Week 4 or 5 D) Week 6 or 7 <div style=padding-top: 35px>
Use the information in Table 13.1. If the safety stock level were 30 units instead of 0 units, in which week would the first planned receipt occur?

A) Week 1
B) Week 2 or 3
C) Week 4 or 5
D) Week 6 or 7
Question
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   What is the total planned order release quantity for item QRS? (Sum up the planned order releases for all 8 weeks)</strong> A) less than or equal to 100 units B) greater than 100 units but less than or equal to 200 units C) greater than 200 units but less than or equal to 300 units D) greater than 300 units <div style=padding-top: 35px> What is the total planned order release quantity for item QRS? (Sum up the planned order releases for all 8 weeks)

A) less than or equal to 100 units
B) greater than 100 units but less than or equal to 200 units
C) greater than 200 units but less than or equal to 300 units
D) greater than 300 units
Question
The Bill of Resources is a list of

A) staff time needed to manufacture an item.
B) all resources needed to provide a service.
C) staff time needed to provide a service.
D) raw materials needed to provide a service.
Question
Table 13.4
Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS
start quantities.
Week
<strong>Table 13.4 Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B. -Subassembly B uses 1 each of component D. Selected Inventory Data Item   Use the information in Table 13.4. Which one of the following statements concerning item B is TRUE?</strong> A) The first planned order release occurs in week 3. B) There are exactly 2 planned order releases. C) The projected on- hand quantity at the end of week 6 is 60 units. D) There are no action notices needed. <div style=padding-top: 35px>
Bill of Material
-Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B.
-Subassembly B uses 1 each of component D.
Selected Inventory Data
Item
<strong>Table 13.4 Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B. -Subassembly B uses 1 each of component D. Selected Inventory Data Item   Use the information in Table 13.4. Which one of the following statements concerning item B is TRUE?</strong> A) The first planned order release occurs in week 3. B) There are exactly 2 planned order releases. C) The projected on- hand quantity at the end of week 6 is 60 units. D) There are no action notices needed. <div style=padding-top: 35px>
Use the information in Table 13.4. Which one of the following statements concerning item B is TRUE?

A) The first planned order release occurs in week 3.
B) There are exactly 2 planned order releases.
C) The projected on- hand quantity at the end of week 6 is 60 units.
D) There are no action notices needed.
Question
Which of the following statements regarding the output from MRP systems is FALSE?

A) A materials requirement plan is generated for each component item.
B) Action notices are generated to make decisions about releasing new orders and adjusting the due dates of scheduled receipts.
C) Priority reports such as dispatch lists and supplier schedules are generated.
D) Typically the capacity limitations of processing equipment are explicitly recognized by MRP systems when planned orders are calculated.
Question
The lot- sizing rule that generates the highest level of average inventory because it creates inventory remnants is

A) periodic order quantity (POQ).
B) lot- for- lot (L4L).
C) fixed order quantity (FOQ).
D) usage quantity.
Question
If a planned receipt for an item is due in week 6 and the item's lead time is 2 weeks, in which week will the corresponding planned order release occur?

A) Week 2
B) Week 4
C) Week 6
D) Week 8
Question
A higher than normal level of equipment failures on the shop floor is likely to be detected from which of the following reports?

A) overhead allocation report
B) vendor shortage report
C) input/output control report
D) customer forecast report
Question
Table 13.7.
<strong> Table 13.7.   Use the information from Table 13.7. Which lot sizing rule results in the highest average inventory?</strong> A) POQ, P = 3 B) FOQ = 75 C) FOQ = 100 D) L4L <div style=padding-top: 35px>
Use the information from Table 13.7. Which lot sizing rule results in the highest average inventory?

A) POQ, P = 3
B) FOQ = 75
C) FOQ = 100
D) L4L
Question
Which one of the following statements about MRP is best?

A) The fixed order quantity rule results in remnants.
B) MRP uses a level- by- level processing procedure; the component items are processed first.
C) An action notice should be issued if the scheduled receipt in a period is less than the projected on- hand inventory for that period.
D) The periodic order quantity rule introduces remnants that are used as a buffer against uncertainties.
Question
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   Which one of the following statements about item QRS is TRUE?</strong> A) The total planned order release quantity (summing up all 8 weeks) is 190 units. B) The first planned receipt occurs in week 1. C) Exactly 1 action notice is needed. D) The second planned order release quantity is 90 units. <div style=padding-top: 35px> Which one of the following statements about item QRS is TRUE?

A) The total planned order release quantity (summing up all 8 weeks) is 190 units.
B) The first planned receipt occurs in week 1.
C) Exactly 1 action notice is needed.
D) The second planned order release quantity is 90 units.
Question
Table 13.2.
<strong>Table 13.2.   Use the information in Table 13.2. If the lot sizing was POQ (P = 3) instead of L4L, how many planned order releases would there be?</strong> A) 0 B) 1 or 2 C) 3 D) 4 or more <div style=padding-top: 35px>
Use the information in Table 13.2. If the lot sizing was POQ (P = 3) instead of L4L, how many planned order releases would there be?

A) 0
B) 1 or 2
C) 3
D) 4 or more
Question
Planned lead time for items manufactured in- house includes

A) setup time.
B) materials handling and waiting times.
C) process time.
D) all the above
Question
Which of the following statements about Enterprise Resource Planning (ERP) is TRUE?

A) ERP is specifically designed for salespersons that want to access the system away from the office.
B) ERP allows customers to access the system.
C) ERP does not include quality management.
D) ERP is similar to MRPII, except that it extends to service operations.
Question
Which one of the following is a feature of MRP II, but not available in basic MRP systems?

A) action notices
B) capacity reporting
C) financial reporting
D) dispatch lists
Question
MRP _________ is a process that converts the requirements of various final products into a material requirements plan that specifies the replenishment schedule of all the subassemblies, components, and raw materials needed by the final products.
Question
In MRP, a(n) _______ is any item manufactured from one or more components.
Question
A(n) _________ is a record of all the required materials, equipment time, staff, and other resources needed to provide a service, the parent- component relationship, and the usage quantities.
Question
The _________ is a record of all components of an item, the parent- component relationships, and usage quantities derived from engineering and process design.
Question
In MRP, a(n) _________ is an item that may go through one or more operations to be transformed into or become part of one or more parents.
Question
_________ demand occurs because the quantity required is a function of the demand for the other items held in inventory.
Question
Table 13.8
Sunshine Manufacture produces three products, X, Y, and Z. The production of these end items is controlled by an MRP
system. Each end item X is assembled with two components of A and one component of B. Each end item of Y is assembled
with two components of C and one component of A, each component of C is manufactured from one unit of B. End item Z is
assembled from one unit of D and one unit of C, D is manufactured from one unit of A, and C is manufactured from one unit
of B.
Use the information in Table 13.8. If item C has a manufacturing lead time of two weeks and a planned receipt of 65 units is needed in week 4, which of the following statements is TRUE?

A) The planned order release in week 2 for item C is 130 units.
B) The gross requirements for item B in week 2 is 65 units.
C) The gross requirements for item B in week 2 is 130 units.
D) The gross requirements for item B in week 4 are at least 65 units.
Question
Explain why MRP does a better job of estimating the need to replenish inventory items than does the fixed order quantity system in a dependent demand environment.
Question
A(n) _________ item is the final product sold to a customer.
Question
_________ is a computerized information system developed specifically to aid in managing dependent demand inventory and scheduling replenishment orders.
Question
_________ are orders that have not yet been released to the shop or the supplier.
Question
An _________ is a company- wide process that cuts across functional areas, business
units, geographic regions, and product lines.
Question
_________ is a lot- sizing rule that maintains the same order quantity each time an order is issued.
Question
Which one of the following statements about material requirements planning is TRUE?

A) The distinctive advantages of MRP are greater when there are many BOM levels, large lot sizes, and a manufacturing environment that is not too volatile.
B) Survey results show that most companies adopting MRP have a purely line flow strategy.
C) MRP is intended mainly for MRO (maintenance, repair, and operating supplies) items where the demands are not too "lumpy."
D) The more volatile the manufacturing environment, the more likely it is that an MRP installation will be successful.
Question
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   Which one of the statements concerning item LMN is TRUE?</strong> A) The planned receipt quantity in week 6 is 30 units. B) There will be exactly 2 action notices needed. C) The projected on- hand inventory in week 8 is 70 units. D) The planned order release quantity in week 4 is 80 units. <div style=padding-top: 35px> Which one of the statements concerning item LMN is TRUE?

A) The planned receipt quantity in week 6 is 30 units.
B) There will be exactly 2 action notices needed.
C) The projected on- hand inventory in week 8 is 70 units.
D) The planned order release quantity in week 4 is 80 units.
Question
In an MRP system, a(n) _________ item has at least one parent and at least one component.
Question
_________ systems are large, integrated information systems that support many enterprise
processes and data storage needs.
Question
Which of the following statements about MRP is TRUE?

A) MRP gross requirements for a parent item are equal to the planned order releases of its components.
B) MRP gross requirements for a component depend on the planned order releases of its immediate parents.
C) To be classified as a successful MRP user, a company must use either the L4L or POQ rules for lot sizing.
D) MRP logic is based on the logic of uniform, continuous demand, and item independence.
Question
Which of the following statements concerning MRP is TRUE?

A) Capacity requirements planning (CRP) uses open orders (scheduled receipts) and planned order releases to estimate capacity requirements for critical workstations.
B) The most accurate way to forecast dependent demand is to examine past usage rates.
C) MRP systems use independent demands for each component item.
D) Dependent demand items tend to experience relatively constant demand rates.
Unlock Deck
Sign up to unlock the cards in this deck!
Unlock Deck
Unlock Deck
1/174
auto play flashcards
Play
simple tutorial
Full screen (f)
exit full mode
Deck 13: Resource Planning
1
Table 13.3
Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s).
Week
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item    Master Production Schedule: the following table shows the MPS start quantities. Use the information in Table 13.3. Which one of the following statements about item E is TRUE?</strong> A) There will be an action notice to expedite the scheduled receipt up to week 2. B) There is one planned receipt for the next 6 weeks. C) There is a planned order release of 250 units in week 3. D) There is a planned receipt of 250 units in week 2.
Bill of Material
-End item A uses 1 each of component C and 1 each of subassembly D.
-Subassembly D uses 2 each of component E and 2 each of component F.
-End item B uses 1 each of component C and 2 each of component F.
Selected Inventory Data
Item
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item    Master Production Schedule: the following table shows the MPS start quantities. Use the information in Table 13.3. Which one of the following statements about item E is TRUE?</strong> A) There will be an action notice to expedite the scheduled receipt up to week 2. B) There is one planned receipt for the next 6 weeks. C) There is a planned order release of 250 units in week 3. D) There is a planned receipt of 250 units in week 2.

Master Production Schedule: the following table shows the MPS start quantities.
Use the information in Table 13.3. Which one of the following statements about item E is TRUE?

A) There will be an action notice to expedite the scheduled receipt up to week 2.
B) There is one planned receipt for the next 6 weeks.
C) There is a planned order release of 250 units in week 3.
D) There is a planned receipt of 250 units in week 2.
There will be an action notice to expedite the scheduled receipt up to week 2.
2
One of the differences between Enterprise Resource Planning (ERP) and MRPII is that

A) ERP is limited to operations internal to the enterprise.
B) ERP is linked to the external supply chain, but MRPII is not.
C) ERP applies only to those operations that are external to the enterprise.
D) ERP includes both manufacturing and service operations.
ERP is linked to the external supply chain, but MRPII is not.
3
The action notice is a

A) secret document to prompt actions to be taken against some suppliers.
B) computer- generated document that helps make decisions about releasing new orders.
C) document that records the most recent important actions taken in the context of MRP.
D) legal notice served by a customer whose order was delayed.
computer- generated document that helps make decisions about releasing new orders.
4
Table 13.6
<strong>Table 13.6   Use the information from Table 13.6. What is the planned receipts quantity in week 3?</strong> A) 0 units B) 10 units C) 20 units D) 30 units
Use the information from Table 13.6. What is the planned receipts quantity in week 3?

A) 0 units
B) 10 units
C) 20 units
D) 30 units
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
5
Complete the following MRP record in order to answer the question. <strong>Complete the following MRP record in order to answer the question.   How many action notices will there be for item XYZ?</strong> A) 0 B) 1 C) 2 D) 3 or more How many action notices will there be for item XYZ?

A) 0
B) 1
C) 2
D) 3 or more
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
6
Management wishes to use a POQ lot- sizing rule for an item that experiences an average demand of 30 units per week. If the desired average lot size is 120 units, what should P be?

A) 0 or 1 weeks
B) 2 or 3 weeks
C) 4 or 5 weeks
D) More than 5 weeks
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
7
Which best defines the gross requirements for a component item?

A) the forecasted customer demand for the component
B) the total demand for the component derived from all immediate parents
C) the sum of gross requirements for all parents of the component
D) the amount of safety stock needed to buffer against uncertainties
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
8
Which of the following statements about MRP II is TRUE?

A) It provides more extensive information than MRP because it is tied to the company's financial system.
B) It incorporates informal systems through the use of expert systems technology.
C) It is computationally faster than regular MRP.
D) It is limited only to aiding order- launching decisions.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
9
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   How large is the second planned order release?</strong> A) less than or equal to 50 units B) greater than 50 units but less than or equal to 100 units C) greater than 100 units but less than or equal to 150 units D) greater than 150 units How large is the second planned order release?

A) less than or equal to 50 units
B) greater than 50 units but less than or equal to 100 units
C) greater than 100 units but less than or equal to 150 units
D) greater than 150 units
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
10
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   What are the quantities of planned order releases for item DEF for the first five weeks (weeks 1, 2, 3, 4, and 5)?</strong> A) 0, 30, 60, 0, 0 B) 30, 0, 60, 145, 0 C) 60, 0, 145, 0, 0 D) 30, 0, 60, 0, 145 What are the quantities of planned order releases for item DEF for the first five weeks (weeks 1, 2, 3, 4, and 5)?

A) 0, 30, 60, 0, 0
B) 30, 0, 60, 145, 0
C) 60, 0, 145, 0, 0
D) 30, 0, 60, 0, 145
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
11
The purpose of Finite Capacity Scheduling is to

A) schedule a group of jobs across all work centers.
B) schedule all jobs for a finite amount of time.
C) limit the total capacity to be used in a day.
D) schedule by hand when MRP fails.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
12
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   How many action notices are needed for item A?</strong> A) 0 B) 1 C) 2 D) 3 or more How many action notices are needed for item A?

A) 0
B) 1
C) 2
D) 3 or more
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
13
Table 13.5.
<strong>Table 13.5.   Use the information in Table 13.5. Which of the statements concerning item RST is TRUE? (Examine each answer independently.)</strong> A) If the scheduled receipt in week 2 were delayed until week 3, there would be a planned order release in week 1. B) If the gross requirements for week 8 were 100 units instead of 60 units, the projected on- hand inventory for week 8 would be 0 units. C) If the safety stock level was 20 units instead of 0 units, there would be a planned order release in week 2. D) If the safety stock level were 30 units instead of 0 units, the planned receipt in week 7 would be 110 units.
Use the information in Table 13.5. Which of the statements concerning item RST is TRUE? (Examine each answer independently.)

A) If the scheduled receipt in week 2 were delayed until week 3, there would be a planned order release in week 1.
B) If the gross requirements for week 8 were 100 units instead of 60 units, the projected on- hand inventory for week 8 would be 0 units.
C) If the safety stock level was 20 units instead of 0 units, there would be a planned order release in week 2.
D) If the safety stock level were 30 units instead of 0 units, the planned receipt in week 7 would be 110 units.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
14
Which one of the following is an MRP lot- sizing rule that attempts to minimize the amount of average inventory?

A) Fixed order quantity (FOQ)
B) Periodic order quantity (POQ), with P = 2
C) Economic order quantity (EOQ)
D) Lot for lot (L4L)
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
15
Table 13.7.
<strong>Table 13.7.   Use the information from Table 13.7. If a POQ lot- sizing rule is used, where P = 3, how many planned order releases are there for item XYZ?</strong> A) 0 or 1 B) 2 or 3 C) 4 or 5 D) more than 5
Use the information from Table 13.7. If a POQ lot- sizing rule is used, where P = 3, how many planned order releases are there for item XYZ?

A) 0 or 1
B) 2 or 3
C) 4 or 5
D) more than 5
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
16
A technique for projecting time- phased requirements for critical workstations is a definition of

A) distribution requirements planning.
B) capacity requirements planning.
C) manufacturing resource planning.
D) material requirements planning.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
17
Which of the following statements about MRP is TRUE?

A) MRP may generate a planned order release that exceeds current production capacity.
B) MRP always recognizes capacity limitations in production as well as human resources.
C) Capacity limitations are implicit in all MRP calculations.
D) MRP recognizes the capacity limitations in production, but not in human resources.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
18
Table 13.7
<strong>Table 13.7   Use the information from Table 13.7. If a FOQ of 75 units is used, how many planned order releases are there for item XYZ?</strong> A) 0 or 1 B) 2 or 3 C) 4 or 5 D) more than 5
Use the information from Table 13.7. If a FOQ of 75 units is used, how many planned order releases are there for item XYZ?

A) 0 or 1
B) 2 or 3
C) 4 or 5
D) more than 5
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
19
Table 13.3
Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s).
Master Production Schedule: the following table shows the MPS start quantities.
Week
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item   Use the information in Table 13.3. Which one of the following statements about item C is TRUE?</strong> A) It has a planned receipt of 80 units in week 3. B) It has a planned receipt of 180 units in week 6. C) Its first planned order release is for 130 units in week 1. D) Its second planned order release is for 200 units in week 3.
Bill of Material
-End item A uses 1 each of component C and 1 each of subassembly D.
-Subassembly D uses 2 each of component E and 2 each of component F.
-End item B uses 1 each of component C and 2 each of component F.
Selected Inventory Data
Item
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item   Use the information in Table 13.3. Which one of the following statements about item C is TRUE?</strong> A) It has a planned receipt of 80 units in week 3. B) It has a planned receipt of 180 units in week 6. C) Its first planned order release is for 130 units in week 1. D) Its second planned order release is for 200 units in week 3.
Use the information in Table 13.3. Which one of the following statements about item C is TRUE?

A) It has a planned receipt of 80 units in week 3.
B) It has a planned receipt of 180 units in week 6.
C) Its first planned order release is for 130 units in week 1.
D) Its second planned order release is for 200 units in week 3.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
20
A term for systems that are large, integrated information systems which support many enterprise processes and data storage needs is called

A) standard resource planning.
B) material resource planning.
C) enterprise resource planning.
D) effective resource planning.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
21
Which one of the following statements concerning MRP is TRUE?

A) The scheduled receipts for a parent item are used to calculate the gross requirements for components of that parent.
B) Some of the key inputs to a computerized MRP system are inventory records, updated bills of material, and a valid master production schedule.
C) One of the main prerequisites for implementing an MRP system is to have products with few BOM levels.
D) Benefits of a successful MRP implementation typically include a decrease in the number of inventory turns, and an increase in the number of expediters.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
22
Table 13.1
<strong>Table 13.1   Use the information in Table 13.1. In which week will the second planned order release occur?</strong> A) Week 1 B) Week 2 C) Week 3 D) Week 4, 5, 6, 7 or 8
Use the information in Table 13.1. In which week will the second planned order release occur?

A) Week 1
B) Week 2
C) Week 3
D) Week 4, 5, 6, 7 or 8
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
23
Table 13.3
Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s).
Master Production Schedule: the following table shows the MPS start quantities.
Week
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item   Use the information in Table 13.3. Which one of the following statements on item C is TRUE?</strong> A) There will be more than two action notices. B) There will be exactly two action notices, to release a new order and delay the scheduled receipt. C) There will be exactly one action notice, to release a new order. D) There will be no action notices for item C.
Bill of Material
-End item A uses 1 each of component C and 1 each of subassembly D.
-Subassembly D uses 2 each of component E and 2 each of component F.
-End item B uses 1 each of component C and 2 each of component F.
Selected Inventory Data
Item
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item   Use the information in Table 13.3. Which one of the following statements on item C is TRUE?</strong> A) There will be more than two action notices. B) There will be exactly two action notices, to release a new order and delay the scheduled receipt. C) There will be exactly one action notice, to release a new order. D) There will be no action notices for item C.
Use the information in Table 13.3. Which one of the following statements on item C is TRUE?

A) There will be more than two action notices.
B) There will be exactly two action notices, to release a new order and delay the scheduled receipt.
C) There will be exactly one action notice, to release a new order.
D) There will be no action notices for item C.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
24
Table 13.5.
<strong>Table 13.5.   Use the information in Table 13.5. Which one of the statements concerning item RST is TRUE?</strong> A) The first planned receipt occurs in week 5. B) There are exactly two planned order releases needed. C) There is an action notice needed to expedite the schedule receipt by one week. D) The planned receipt in week 7 is 80 units.
Use the information in Table 13.5. Which one of the statements concerning item RST is TRUE?

A) The first planned receipt occurs in week 5.
B) There are exactly two planned order releases needed.
C) There is an action notice needed to expedite the schedule receipt by one week.
D) The planned receipt in week 7 is 80 units.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
25
Table 13.8
Sunshine Manufacture produces three products, X, Y, and Z. The production of these end items is controlled by an MRP
system. Each end item X is assembled with two components of A and one component of B. Each end item of Y is assembled
with two components of C and one component of A, each component of C is manufactured from one unit of B. End item Z is
assembled from one unit of D and one unit of C, D is manufactured from one unit of A, and C is manufactured from one unit
of B.
Use the information in Table 13.8. If level- by- level processing is used, what is a correct order for processing components A, B, C, and D?

A) A B C D
B) D A B C
C) C B A D
D) C D A B
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
26
Table 13.3
Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s).
Master Production Schedule: the following table shows the MPS start quantities.
Week
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item   Use the information in Table 13.3. Which one of the following statements about item F is TRUE?</strong> A) Its first planned receipt is for 215 units in week 4. B) There will be exactly one action notice, which calls for the release of a new order. C) There will be exactly one action notice, which calls for the delay of the scheduled receipt until week 2. D) The first planned order release is for 205 units in week 3.
Bill of Material
-End item A uses 1 each of component C and 1 each of subassembly D.
-Subassembly D uses 2 each of component E and 2 each of component F.
-End item B uses 1 each of component C and 2 each of component F.
Selected Inventory Data
Item
<strong>Table 13.3 Consider the following MPS, BOM, and inventory data. You will need a blank MRP record to answer the question(s). Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -End item A uses 1 each of component C and 1 each of subassembly D. -Subassembly D uses 2 each of component E and 2 each of component F. -End item B uses 1 each of component C and 2 each of component F. Selected Inventory Data Item   Use the information in Table 13.3. Which one of the following statements about item F is TRUE?</strong> A) Its first planned receipt is for 215 units in week 4. B) There will be exactly one action notice, which calls for the release of a new order. C) There will be exactly one action notice, which calls for the delay of the scheduled receipt until week 2. D) The first planned order release is for 205 units in week 3.
Use the information in Table 13.3. Which one of the following statements about item F is TRUE?

A) Its first planned receipt is for 215 units in week 4.
B) There will be exactly one action notice, which calls for the release of a new order.
C) There will be exactly one action notice, which calls for the delay of the scheduled receipt until week 2.
D) The first planned order release is for 205 units in week 3.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
27
Table 13.7
<strong>Table 13.7   Use the information from Table 13.7. If a FOQ of 100 units is used, how many planned order releases are there for item XYZ?</strong> A) 0 or 1 B) 2 or 3 C) 4 or 5 D) more than 5
Use the information from Table 13.7. If a FOQ of 100 units is used, how many planned order releases are there for item XYZ?

A) 0 or 1
B) 2 or 3
C) 4 or 5
D) more than 5
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
28
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   What are the quantity and the week of the first planned order release?</strong> A) 150 units: week 2 B) 140 units; week 2 C) 150 units; week 1 D) 20 units; week 1 What are the quantity and the week of the first planned order release?

A) 150 units: week 2
B) 140 units; week 2
C) 150 units; week 1
D) 20 units; week 1
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
29
Which one of the following statements about lot- sizing rules is TRUE?

A) If the POQ rule is used, an item's lot size can vary each time an order is placed.
B) The periodic order quantity (POQ) rule seeks to create inventory remnants.
C) The lot for lot (L4L) rule is a special case of the fixed order quantity (FOQ) rule.
D) All lot- sizing rules seek to minimize inventory levels.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
30
Table 13.2.
<strong>Table 13.2.   Use the information in Table 13.2. How many planned order releases are there for item XYZ?</strong> A) 3 B) 4 or more C) 0 D) 1 or 2
Use the information in Table 13.2. How many planned order releases are there for item XYZ?

A) 3
B) 4 or more
C) 0
D) 1 or 2
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
31
Which one of the following systems is an input to the MRP system?

A) purchasing system
B) master production scheduling system
C) financial reporting system
D) shop floor scheduling system
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
32
Use the following MRP record to answer the following question. <strong>Use the following MRP record to answer the following question.   What is the planned order release quantity in week 4?</strong> A) 0 units B) greater than 0 units but less than or equal to 50 units C) greater than 50 units but less than or equal to 100 units D) greater than 100 units What is the planned order release quantity in week 4?

A) 0 units
B) greater than 0 units but less than or equal to 50 units
C) greater than 50 units but less than or equal to 100 units
D) greater than 100 units
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
33
Planned lead time for purchased items is

A) order processing time.
B) setup time plus materials handling time plus waiting time.
C) time difference between when the order was issued and when it would be received from the supplier.
D) setup time plus processing time plus waiting time.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
34
The underlying logic for level- by- level processing in an MRP system is

A) all parents of an item must be processed before that item is processed.
B) items without safety stock quantities must be processed before items that have safety stocks greater than zero.
C) each item in a bill of material must be processed from the bottom up.
D) items must be processed in order of increasing lead time.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
35
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   What are the quantities of planned order releases for item XYZ for the first six weeks (weeks 1, 2, 3, 4, 5, and 6)?</strong> A) 35, 0, 60, 0, 0, 0 B) 5, 30, 0, 40, 20, 0 C) 35, 0, 0, 40, 20, 0 D) 35, 0, 0, 60, 0, 0 What are the quantities of planned order releases for item XYZ for the first six weeks (weeks 1, 2, 3, 4, 5, and 6)?

A) 35, 0, 60, 0, 0, 0
B) 5, 30, 0, 40, 20, 0
C) 35, 0, 0, 40, 20, 0
D) 35, 0, 0, 60, 0, 0
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
36
A resource planning process takes

A) buying and production plan; processes information in the way of time standards, routings, and other information on how the firm produces its services or products; and then plans the input requirements.
B) sales and operation plan; processes information in the way of time standards, routings, and other information on how the firm produces its services or products; and then plans the input requirements.
C) marketing and distribution plan; processes information in the way of time standards, routings, and other information on how the firm produces its services or products; and then plans the input requirements.
D) modelling and branding plan; processes information in the way of time standards, routings, and other information on how the firm produces its services or products; and then plans the input requirements.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
37
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   What will be the projected on- hand inventory quantity in week 8?</strong> A) less than or equal to 30 units B) greater than 30 units but less than or equal to 60 units C) greater than 60 units but less than or equal to 90 units D) greater than 90 units What will be the projected on- hand inventory quantity in week 8?

A) less than or equal to 30 units
B) greater than 30 units but less than or equal to 60 units
C) greater than 60 units but less than or equal to 90 units
D) greater than 90 units
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
38
Table 13.7.
<strong>Table 13.7.   Use the information from Table 13.7. If a L4L lot- sizing rule is used, how many planned order releases are there for item XYZ?</strong> A) 0 or 1 B) 2 or 3 C) 4 or 5 D) more than 5
Use the information from Table 13.7. If a L4L lot- sizing rule is used, how many planned order releases are there for item XYZ?

A) 0 or 1
B) 2 or 3
C) 4 or 5
D) more than 5
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
39
One of the three types of MRP action notices possible is releasing a new order. Which one of the following statements is TRUE about releasing a new order?

A) Release an order when the first period's gross requirements quantity is equal to zero.
B) Release a separate order for service parts.
C) Release an order when there is a nonzero quantity in the scheduled receipt row.
D) Release an order when there is a nonzero quantity in the first period's planned order release row.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
40
MRP explosion means estimating the total number of

A) parts to be produced for each parent item.
B) parts needed to be produced less the number of parts on hand for each parent item.
C) raw materials to be purchased from all suppliers.
D) subassemblies, components, and raw materials needed for each parent item.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
41
Table 13.6.
<strong> Table 13.6.   Use the information from Table 13.6. If the lot- sizing rule were L4L instead of FOQ = 30 units, what would be the planned order release quantity week 1?</strong> A) 0 units B) 10 units C) 20 units D) 40 units
Use the information from Table 13.6. If the lot- sizing rule were L4L instead of FOQ = 30 units, what would be the planned order release quantity week 1?

A) 0 units
B) 10 units
C) 20 units
D) 40 units
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
42
Management wishes to use a FOQ lot- sizing rule for an item based on the economic order quantity. If the annual demand is 1200 units, the holding cost is $10/unit/year, and the setup cost is $50/lot, which one of the following fixed order quantities is most appropriate?

A) 90 units
B) 110 units
C) 130 units
D) 150 units
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
43
Which of the following statements on MRP is TRUE?

A) MRP is an inventory control system that derives the gross requirements of the end items from purchase commitments with vendors.
B) The payoffs from MRP tend to be greater when there are more BOM levels and larger lot sizes.
C) The fixed order quantity (FOQ) eliminates remnants.
D) When MRP systems are enhanced to include financial reporting they are called basic MRP systems, or "little mrp."
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
44
Table 13.4
Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS
start quantities.
Week
<strong>Table 13.4 Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B. -Subassembly B uses 1 each of component D. Selected Inventory Data Item   Use the information in Table 13.4. What are the total planned receipts for item D? (Sum up the planned receipts for all periods.)</strong> A) less than or equal to 80 units B) greater than 80 units but less than or equal to 100 units C) greater than 100 units but less than or equal to 240 units D) greater than 240 units.
Bill of Material
-Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B.
-Subassembly B uses 1 each of component D.
Selected Inventory Data
Item
<strong>Table 13.4 Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B. -Subassembly B uses 1 each of component D. Selected Inventory Data Item   Use the information in Table 13.4. What are the total planned receipts for item D? (Sum up the planned receipts for all periods.)</strong> A) less than or equal to 80 units B) greater than 80 units but less than or equal to 100 units C) greater than 100 units but less than or equal to 240 units D) greater than 240 units.
Use the information in Table 13.4. What are the total planned receipts for item D? (Sum up the planned receipts for all periods.)

A) less than or equal to 80 units
B) greater than 80 units but less than or equal to 100 units
C) greater than 100 units but less than or equal to 240 units
D) greater than 240 units.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
45
Table 13.4
Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS
start quantities.
Week
<strong>Table 13.4 Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B. -Subassembly B uses 1 each of component D. Selected Inventory Data Item   Use the information in Table 13.4. When does the first planned order release for item C occur?</strong> A) Week 1 or 2 B) Week 3 C) Week 4 D) No planned order releases needed
Bill of Material
-Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B.
-Subassembly B uses 1 each of component D.
Selected Inventory Data
Item
<strong>Table 13.4 Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B. -Subassembly B uses 1 each of component D. Selected Inventory Data Item   Use the information in Table 13.4. When does the first planned order release for item C occur?</strong> A) Week 1 or 2 B) Week 3 C) Week 4 D) No planned order releases needed
Use the information in Table 13.4. When does the first planned order release for item C occur?

A) Week 1 or 2
B) Week 3
C) Week 4
D) No planned order releases needed
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
46
Which of the following statements about lot- sizing rules for MRP is TRUE?

A) The lot- for- lot rule minimizes inventory investment, but maximizes the number of orders placed.
B) The periodic order quantity (POQ) rule generates a higher level of average inventory, because it creates inventory remnants.
C) In general, the fixed order quantity rule introduces greater instability into the production process.
D) FOQ reduces the amount of inventory on hand, by doing a better job of matching the order quantity the projected on- hand inventory quantity.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
47
Table 13.1.
<strong>Table 13.1.   Use the information in Table 13.1. If the safety stock level were 30 units instead of 0 units, in which week would the first planned receipt occur?</strong> A) Week 1 B) Week 2 or 3 C) Week 4 or 5 D) Week 6 or 7
Use the information in Table 13.1. If the safety stock level were 30 units instead of 0 units, in which week would the first planned receipt occur?

A) Week 1
B) Week 2 or 3
C) Week 4 or 5
D) Week 6 or 7
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
48
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   What is the total planned order release quantity for item QRS? (Sum up the planned order releases for all 8 weeks)</strong> A) less than or equal to 100 units B) greater than 100 units but less than or equal to 200 units C) greater than 200 units but less than or equal to 300 units D) greater than 300 units What is the total planned order release quantity for item QRS? (Sum up the planned order releases for all 8 weeks)

A) less than or equal to 100 units
B) greater than 100 units but less than or equal to 200 units
C) greater than 200 units but less than or equal to 300 units
D) greater than 300 units
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
49
The Bill of Resources is a list of

A) staff time needed to manufacture an item.
B) all resources needed to provide a service.
C) staff time needed to provide a service.
D) raw materials needed to provide a service.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
50
Table 13.4
Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS
start quantities.
Week
<strong>Table 13.4 Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B. -Subassembly B uses 1 each of component D. Selected Inventory Data Item   Use the information in Table 13.4. Which one of the following statements concerning item B is TRUE?</strong> A) The first planned order release occurs in week 3. B) There are exactly 2 planned order releases. C) The projected on- hand quantity at the end of week 6 is 60 units. D) There are no action notices needed.
Bill of Material
-Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B.
-Subassembly B uses 1 each of component D.
Selected Inventory Data
Item
<strong>Table 13.4 Consider the MPS, BOM and inventory data shown below. Master Production Schedule: the following table shows the MPS start quantities. Week   Bill of Material -Item A uses 1 each of component D, 2 each of component C and 2 each of subassembly B. -Subassembly B uses 1 each of component D. Selected Inventory Data Item   Use the information in Table 13.4. Which one of the following statements concerning item B is TRUE?</strong> A) The first planned order release occurs in week 3. B) There are exactly 2 planned order releases. C) The projected on- hand quantity at the end of week 6 is 60 units. D) There are no action notices needed.
Use the information in Table 13.4. Which one of the following statements concerning item B is TRUE?

A) The first planned order release occurs in week 3.
B) There are exactly 2 planned order releases.
C) The projected on- hand quantity at the end of week 6 is 60 units.
D) There are no action notices needed.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
51
Which of the following statements regarding the output from MRP systems is FALSE?

A) A materials requirement plan is generated for each component item.
B) Action notices are generated to make decisions about releasing new orders and adjusting the due dates of scheduled receipts.
C) Priority reports such as dispatch lists and supplier schedules are generated.
D) Typically the capacity limitations of processing equipment are explicitly recognized by MRP systems when planned orders are calculated.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
52
The lot- sizing rule that generates the highest level of average inventory because it creates inventory remnants is

A) periodic order quantity (POQ).
B) lot- for- lot (L4L).
C) fixed order quantity (FOQ).
D) usage quantity.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
53
If a planned receipt for an item is due in week 6 and the item's lead time is 2 weeks, in which week will the corresponding planned order release occur?

A) Week 2
B) Week 4
C) Week 6
D) Week 8
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
54
A higher than normal level of equipment failures on the shop floor is likely to be detected from which of the following reports?

A) overhead allocation report
B) vendor shortage report
C) input/output control report
D) customer forecast report
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
55
Table 13.7.
<strong> Table 13.7.   Use the information from Table 13.7. Which lot sizing rule results in the highest average inventory?</strong> A) POQ, P = 3 B) FOQ = 75 C) FOQ = 100 D) L4L
Use the information from Table 13.7. Which lot sizing rule results in the highest average inventory?

A) POQ, P = 3
B) FOQ = 75
C) FOQ = 100
D) L4L
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
56
Which one of the following statements about MRP is best?

A) The fixed order quantity rule results in remnants.
B) MRP uses a level- by- level processing procedure; the component items are processed first.
C) An action notice should be issued if the scheduled receipt in a period is less than the projected on- hand inventory for that period.
D) The periodic order quantity rule introduces remnants that are used as a buffer against uncertainties.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
57
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   Which one of the following statements about item QRS is TRUE?</strong> A) The total planned order release quantity (summing up all 8 weeks) is 190 units. B) The first planned receipt occurs in week 1. C) Exactly 1 action notice is needed. D) The second planned order release quantity is 90 units. Which one of the following statements about item QRS is TRUE?

A) The total planned order release quantity (summing up all 8 weeks) is 190 units.
B) The first planned receipt occurs in week 1.
C) Exactly 1 action notice is needed.
D) The second planned order release quantity is 90 units.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
58
Table 13.2.
<strong>Table 13.2.   Use the information in Table 13.2. If the lot sizing was POQ (P = 3) instead of L4L, how many planned order releases would there be?</strong> A) 0 B) 1 or 2 C) 3 D) 4 or more
Use the information in Table 13.2. If the lot sizing was POQ (P = 3) instead of L4L, how many planned order releases would there be?

A) 0
B) 1 or 2
C) 3
D) 4 or more
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
59
Planned lead time for items manufactured in- house includes

A) setup time.
B) materials handling and waiting times.
C) process time.
D) all the above
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
60
Which of the following statements about Enterprise Resource Planning (ERP) is TRUE?

A) ERP is specifically designed for salespersons that want to access the system away from the office.
B) ERP allows customers to access the system.
C) ERP does not include quality management.
D) ERP is similar to MRPII, except that it extends to service operations.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
61
Which one of the following is a feature of MRP II, but not available in basic MRP systems?

A) action notices
B) capacity reporting
C) financial reporting
D) dispatch lists
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
62
MRP _________ is a process that converts the requirements of various final products into a material requirements plan that specifies the replenishment schedule of all the subassemblies, components, and raw materials needed by the final products.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
63
In MRP, a(n) _______ is any item manufactured from one or more components.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
64
A(n) _________ is a record of all the required materials, equipment time, staff, and other resources needed to provide a service, the parent- component relationship, and the usage quantities.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
65
The _________ is a record of all components of an item, the parent- component relationships, and usage quantities derived from engineering and process design.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
66
In MRP, a(n) _________ is an item that may go through one or more operations to be transformed into or become part of one or more parents.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
67
_________ demand occurs because the quantity required is a function of the demand for the other items held in inventory.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
68
Table 13.8
Sunshine Manufacture produces three products, X, Y, and Z. The production of these end items is controlled by an MRP
system. Each end item X is assembled with two components of A and one component of B. Each end item of Y is assembled
with two components of C and one component of A, each component of C is manufactured from one unit of B. End item Z is
assembled from one unit of D and one unit of C, D is manufactured from one unit of A, and C is manufactured from one unit
of B.
Use the information in Table 13.8. If item C has a manufacturing lead time of two weeks and a planned receipt of 65 units is needed in week 4, which of the following statements is TRUE?

A) The planned order release in week 2 for item C is 130 units.
B) The gross requirements for item B in week 2 is 65 units.
C) The gross requirements for item B in week 2 is 130 units.
D) The gross requirements for item B in week 4 are at least 65 units.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
69
Explain why MRP does a better job of estimating the need to replenish inventory items than does the fixed order quantity system in a dependent demand environment.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
70
A(n) _________ item is the final product sold to a customer.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
71
_________ is a computerized information system developed specifically to aid in managing dependent demand inventory and scheduling replenishment orders.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
72
_________ are orders that have not yet been released to the shop or the supplier.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
73
An _________ is a company- wide process that cuts across functional areas, business
units, geographic regions, and product lines.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
74
_________ is a lot- sizing rule that maintains the same order quantity each time an order is issued.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
75
Which one of the following statements about material requirements planning is TRUE?

A) The distinctive advantages of MRP are greater when there are many BOM levels, large lot sizes, and a manufacturing environment that is not too volatile.
B) Survey results show that most companies adopting MRP have a purely line flow strategy.
C) MRP is intended mainly for MRO (maintenance, repair, and operating supplies) items where the demands are not too "lumpy."
D) The more volatile the manufacturing environment, the more likely it is that an MRP installation will be successful.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
76
Use the following MRP record to answer the question. <strong>Use the following MRP record to answer the question.   Which one of the statements concerning item LMN is TRUE?</strong> A) The planned receipt quantity in week 6 is 30 units. B) There will be exactly 2 action notices needed. C) The projected on- hand inventory in week 8 is 70 units. D) The planned order release quantity in week 4 is 80 units. Which one of the statements concerning item LMN is TRUE?

A) The planned receipt quantity in week 6 is 30 units.
B) There will be exactly 2 action notices needed.
C) The projected on- hand inventory in week 8 is 70 units.
D) The planned order release quantity in week 4 is 80 units.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
77
In an MRP system, a(n) _________ item has at least one parent and at least one component.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
78
_________ systems are large, integrated information systems that support many enterprise
processes and data storage needs.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
79
Which of the following statements about MRP is TRUE?

A) MRP gross requirements for a parent item are equal to the planned order releases of its components.
B) MRP gross requirements for a component depend on the planned order releases of its immediate parents.
C) To be classified as a successful MRP user, a company must use either the L4L or POQ rules for lot sizing.
D) MRP logic is based on the logic of uniform, continuous demand, and item independence.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
80
Which of the following statements concerning MRP is TRUE?

A) Capacity requirements planning (CRP) uses open orders (scheduled receipts) and planned order releases to estimate capacity requirements for critical workstations.
B) The most accurate way to forecast dependent demand is to examine past usage rates.
C) MRP systems use independent demands for each component item.
D) Dependent demand items tend to experience relatively constant demand rates.
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
Unlock Deck
k this deck
locked card icon
Unlock Deck
Unlock for access to all 174 flashcards in this deck.
